Dowel Bar Retrofit Construction Practices

Introduction

The following describes and illustrates the dowel bar retrofit construction process. In addition, descriptions of critical details for ensuring pavement performance are also included.

In general, the dowel bar retrofit process includes the following steps:

  1. Using diamond saw blades, sawcut dowel bar slots (three to four per wheelpath).
  2. Remove existing concrete within dowel bar slot.
  3. Remove diamond blade slurry and other debris from dowel bar dowel bar slot.
  4. Seal existing the joint or crack within the dowel bar slot with caulking material.
  5. Place dowel bar assembly (dowel bar, chairs and end caps) into the dowel bar slot, centered over the joint or crack.
  6. Place, consolidate and cure patching material.
  7. Diamond grind surface.

Since dowel bar retrofit performance is highly dependent on construction practices, it is advised that prior to project startup the project inspector consider the following:

  • Familiarization of Construction Plans, Specifications and Special Provisions
  • Consider preconstruction workshop to ensure contractor and agency understand project requirements
  • Consider including experienced personnel during the preconstruction meeting and potentially on the job-site during construction.
  • Bridge approach slabs should not be retrofitted.

Dowel Bar Retrofit and Panel Replacement Guidelines

The following images illustrate general guidelines for applying dowel bar retrofit and panel replacements.

Transverse Crack

Mid panel transverse crack (A and B greater than three feet).
Figure 1: Mid panel transverse crack (A and B greater than three feet).
Existing transverse crack (B < three feet).
Figure 2: Existing transverse crack (B < three feet).

Transverse Working Crack

Working transverse crack.
Figure 3: Working transverse crack.
Working transverse crack.
Figure 4: Working transverse crack.

Multi-Cracked and Settled Slabs

Multi cracked (two or more) and settled (>1/2 inch) slab.
Figure 5: Multi cracked (two or more) and settled (>1/2 inch) slab.

Corner Crack

Working corner crack.
Figure 6: Working corner crack.
Corner crack.
Figure 7: Corner crack.
Longitudinal crack.
Figure 8: Longitudinal crack.

Cutting Dowel Bar Slots

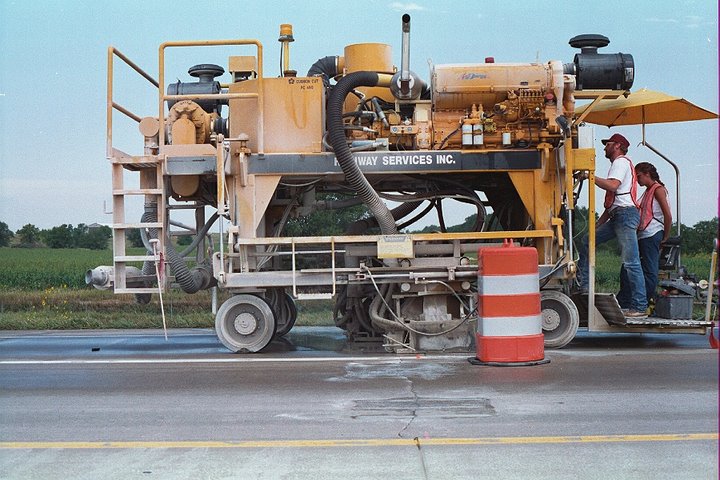

Figure 9 illustrates equipment that can saw cut six dowel bar slots in one pass. This device is very effective in cutting both non skewed and skewed transverse joints. This device is also effective in cutting dowel bar slots on transverse cracks, depending on angle of crack skew.

Cutting equipment for six dowel bar slots per joint.
Figure 9: Cutting equipment for six dowel bar slots per joint.

Figure 10 and Figure 11 shows the three dowel bar slots per wheelpath equipment. This equipment is effective in cutting dowel bar slots on both non-skewed and skewed joints and transverse cracks.

Cutting equipment for three dowel bar slots per wheelpath.
Figure 10: Cutting equipment for three dowel bar slots per wheelpath.

Cutting equipment for three dowel bar slots per joint.
Figure 11: Cutting equipment for three dowel bar slots per joint.

Figure 12 illustrates equipment to saw cut a single dowel bar slot

Cutting equipment for one dowel bar slot at a time.
Figure 12: Cutting equipment for one dowel bar slot at a time.

Figure 13 illustrates the completed sawcutting operation on a non-skewed transverse joint.

Cut dowel bar slots on a non-skewed transverse joint.
Figure 13: Cut dowel bar slots on a non-skewed transverse joint.

For skewed joints, when using sawcutting equipment that is capable of cutting three or more dowel bar slots per wheelpath or six dowel bar slots per joint (in one pass), dowel bar slots should be cut with sufficient length (Figure 14) to allow the dowel bar assembly to be centered over the joint (equal length of dowel bar on either side of the joint).

Proper alignment of the dowel bar slot is essential for minimizing the potential for dowel bar lockup. Lockup is the inability of the dowel bar to move freely as the slab expands and contracts due to curling and warping. If the dowel bar movement is restricted, stresses can be induced within the dowel bar slot and eventual cracking and spalling of patching material may occur. Stresses may also be significant to cause cracking within the concrete panel.

Figure 15 illustrates dowel bar slots that have not been correctly sawcut on a skewed joint. In this case, the dowel bar slots were cut perpendicular to the skewed joint (as is necessary for non-skewed joints) rather than parallel to centerline.

Dowel bar slots on a skewed transverse joint.
Figure 14: Dowel bar slots on a skewed transverse joint.

Dowel bar slots incorrectly cut on skewed joints.
Figure 15: Dowel bar slots incorrectly cut on skewed joints.

Slots cut deeper than necessary can contribute to corner cracking (Figure 16) and patching material failure and the potential of the jackhammer punching through the bottom of the dowel bar slot. The Contractor/Inspector should physically measure (Figure 17) the dowel bar assembly height (including chairs) to ensure proper sawcut depth.

Dowel bar slot cut and/or chipped too deep.
Figure 16: Dowel bar slot cut and/or chipped too deep.

Check depth of dowel bar slot.
Figure 17: Check depth of dowel bar slot.

Dowel bar slot width should also be confirmed to ensure that the dowel bar chairs and foam core board fit snugly against the sides of the dowel bar slot. This will assist in holding the dowel bar assembly securely in the dowel bar slot during placement of the patching material.

Dowel bar slots should be aligned to miss (Figure 18) any existing longitudinal crack. Depending on the wander of the longitudinal crack, dowel bar slots could also be eliminated (Figure 19). If the longitudinal crack was located in the right wheelpath, completely eliminating all dowel bar slots would not be recommended. In this instance, it may be best to place as many dowel bar slots as possible without intersecting the longitudinal crack.

Figure 20 through Figure 21 illustrates instances where the dowel bar slot was not placed to miss the existing longitudinal crack resulting in failure of the patching material. Dowel bar slots placed over a longitudinal crack will fail (Figure A-20) within a very short period of time (< 12 months). The failure mechanism is typically debonding, cracking and spalling of the concrete patching material. Shifting dowel bar slots, three to four inches, will prevent this distress while still providing the required load transfer. If a gang saw is used, dowel bar slots may be sawed but not retrofitted, any non-retrofitted sawcuts should be cleaned and sealed with an epoxy resin.

Dowel bar slots aligned to miss an existing longitudinal crack.
Figure 18: Dowel bar slots aligned to miss an existing longitudinal crack.

Left wheelpath dowel bar slots not installed to avoid existing longitudinal crack.
Figure 19: Left wheelpath dowel bar slots not installed to avoid existing longitudinal crack.

Failure of dowel bar slot placed over existing longitudinal crack.
Figure 20: Failure of dowel bar slot placed over existing longitudinal crack.

Failure of dowel bar slot placed over existing longitudinal crack.
Figure 21: Failure of dowel bar slot placed over existing longitudinal crack.

All existing transverse joints and cracks should be dowel bar retrofitted. Figure 22 shows a non-working joint (narrow joint opening and excellent joint sealant condition after being in-service for more than 20 years with no maintenance) and a transverse crack that is functioning as the working joint. In this case, the crack should be dowel bar retrofitted and not the joint.

Transverse crack is functioning as the working joint.
Figure 22: Transverse crack is functioning as the working joint.

Removing Existing Concrete from Dowel Bar Slots

The existing concrete should be removed from the dowel bar slot using jackhammers weighing 30 pounds or less. Jackhammers should be operated at a 45 degree angle or less (Figure 23 through Figure 25). Jackhammers operated in a vertical position can punch through the bottom of the dowel bar slot.

Maintain jackhammer at no more than a 45-degree angle.
Figure 23: Maintain jackhammer at no more than a 45-degree angle.

Multiple jackhammer operation.
Figure 24: Multiple jackhammer operation.

Removing concrete within dowel bar slot.
Figure 25: Removing concrete within dowel bar slot.

Leveling of the dowel bar slot bottom (Figure 26) helps ensure that the dowel bar will meet alignment tolerances. This work should be conducted with a 15-pound or lighter jackhammer.

Leveling dowel bar slot bottom.
Figure 26: Leveling dowel bar slot bottom.

A breaker bar (Figure 27 and Figure 28) may be used to expedite the jackhammer removal operation of the concrete within the dowel bar slot.

Breaker bar.
Figure 27: Breaker bar.

Figure 29 illustrates insufficient removal of the existing concrete from the bottom of the dowel bar slot. This high point may result in a skew in the horizontal position of the dowel bar beyond that which is allowed by specification tolerances. If this skew is severe, dowel bar lockup and eventual failure of the patching material may occur. Slot bottom should be leveled using a lightweight (< 15 pound) jackhammer.

Breaker bar.
Figure 28: Breaker bar.

Concrete not fully removed from bottom of slot.
Figure 29: Concrete not fully removed from bottom of slot.

Figure 30 illustrates insufficient removal of the existing concrete at the end of the dowel bar slot. Improper concrete removal could result in insufficient length for the dowel bar to sit level in the dowel bar slot and may not allow for sufficient patching material around the dowel bar. Though this may not be extreme in this case, spalling at the end of the dowel bar slot may occur due to difficulty in obtaining patching material consolidation.

Figure 31 illustrates a situation where the jackhammer operation caused failure of the bottom of the dowel bar slot. This may have occurred due to operating the jackhammer at an angle greater than 45 degrees, the dowel bar slot was sawcut to deep leaving an insufficient depth of concrete between the dowel bar slot bottom and the bottom of the concrete slab, which was easily broken during the jackhammering process or the use of jackhammers weighing more than 30 pounds.

Concrete not sufficiently removed from the end of the dowel bar slot.
Figure 30: Concrete not sufficiently removed from the end of the dowel bar slot.

Removal of the dowel bar slot debris from the jackhammering operation can be quite laborious. The use of a small loader can aid in the clean-up operation (Figure 32 through Figure 35).

Jackhammer punching through the bottom of the dowel slot.
Figure 31: Jackhammer punching through the bottom of the dowel slot.

Debris from the jackhammering process.
Figure 32: Debris from the jackhammering process.

Debris being removed by truck .
Figure 33: Debris being removed by truck .

Debris removal.
Figure 34: Debris removal.

Debris removal.
Figure 35: Debris removal.

Cleaning Dowel Bar Slots

After completion of the sawcutting and concrete removal process, debris and saw blade slurry exists in the dowel bar slot (Figure 36). This material must be removed prior to installation of the dowel bar assembly. Insufficient cleaning of the dowel bar slot will prohibit adherence of the patching material to the existing concrete, which will result in a bonding failure between the patching material and the existing concrete.

All exposed surfaces and cracks in the dowel bar slot should be sand blasted (Figure 37 and Figure 38) and cleaned to bare concrete to remove any diamond saw blade slurry or other debris. The dowel bar slot is considered to be clean when all debris and standing water has been removed from the dowel bar slot sides and bottom. The side of the dowel bar slot is considered clean when wiping the sides of the dowel bar slot, with a clean towel or hand, produces no residue.

Compressed air (Figure 40 and Figure 41) may also be used to remove debris, water and slurry from the sides and the bottom of the dowel bar slots.

Sawcut blade residue on slot walls.
Figure 36: Sawcut blade residue on slot walls.

Cleaning dowel bar slot by shot blasting.
Figure 37: Cleaning dowel bar slot by shot blasting.

Dowel bar slot after shot blasting.
Figure 38: Dowel bar slot after shot blasting.

Cleaning shot blasting debris from roadway.
Figure 39: Cleaning shot blasting debris from roadway.

Removing water and other debris with compressed air.
Figure 40: Removing water and other debris with compressed air.

Cleaning dowel bar slots with compressed air.
Figure 41: Cleaning dowel bar slots with compressed air.

Figure 42 shows a properly cleaned dowel bar slot.

Cleaned dowel bar slot.
Figure 42: Cleaned dowel bar slot.

Removal of debris and slurry residue can be challenging if water is present in the dowel bar slot. If water is present (Figure 43), slurry residue is redistributed to the bottom or sides of the dowel bar slots by sandblasting or compressed air. More than one attempt at cleaning the dowel bar slot may be required in obtaining the desired cleanliness.

Water must be removed prior to placement of patching material.
Figure 43: Water must be removed prior to placement of patching material.

Figure 44 and Figure 45 shows debonding of the patching material from the dowel bar slot. This distress is typically related to inadequate cleaning of the dowel bar slot. Repair of this distress requires removal and replacement of the patching material.

Patching material bond failure.
Figure 44: Patching material bond failure.

Patching material bond failure.
Figure 45: Patching material bond failure.

Figure 46 illustrates spalling of the patching material. Potential causes of this distress can be related to consolidation, lack of sufficient aggregate or opening too early to traffic. Figure 47 illustrates insufficient consolidation in the patching material. Repair, for both instances would include removal and replacement of two to three inches in depth of the patching material.

Spalling of patching material.
Figure 46: Spalling of patching material.

Insufficient consolidation of patching material.
Figure 47: Insufficient consolidation of patching material.

Figure 48 illustrates shrinkage cracking of the patching material. This type of cracking is repaired by removal and replacement of distressed patching material.

Shrinkage cracks of pour back material.
Figure 48: Shrinkage cracks of pour back material.

Debris should be removed to a minimum of four feet from the dowel bar slots. This material can be reintroduced (Figure 49) into the dowel bar slot and may result in bonding issues.

Debris should be cleared to a sufficient distance to prevent intrusion.
Figure 49: Debris should be cleared to a sufficient distance to prevent intrusion.

Sealing Joint or Crack within the Dowel Bar Slot

Transverse joints and cracks must be caulked (Figure 50 and Figure 51) within the dowel bar slot. Caulking material should not extend more than ½ inch beyond either side of the joint or crack. The caulking material will prevent patching material from entering the joint/crack.

Caulking dowel bar slot sides and bottom.
Figure 50: Caulking dowel bar slot sides and bottom.

Caulked dowel bar slot.
Figure 51: Caulked dowel bar slot.

Placement of Dowel Bar Assembly

Prior to assembly and placement into the dowel bar slot, dowel bars should be lightly coated with a parting compound. Parting compound that is applied after the dowel bar assembly has been placed in the dowel bar slot will result in debonding of the patching material. Once the parting compound has been applied, foam core board, chairs and end caps should be installed onto the dowel bar.

The chair design should hold the dowel bar tightly and fit snugly against the dowel bar slot such that movement is minimized during placement of the patching material. Chairs should be strong enough to allow full support of the dowel bar. Chairs should allow at least a ½ inch clearance between the bottom of the dowel and the bottom of the dowel bar slot.

End caps shall be tight fitting, placed on each end of the dowel bar, each allowing at least ¼ inch of movement. Loose fitting end caps will allow movement of the dowel bar within the dowel bar slot, which could lead to failure of the patching material. The dowel bar must be allowed to move within the end cap to allow for expansion and contraction due to curling and warping.

The ⅜ inch thick foam core board (closed cell foam with plastic or poster board faced material) should be of sufficient quality to allow a tight fit around the dowel bar and to all edges of the dowel bar slot during placement of the patching material. Care should be given to ensure the foam core board extends beneath the dowel bar to the bottom of the dowel bar slot. The foam core board should be placed at the transverse joint or transverse crack and at the middle of the dowel bar. The foam core board reestablishes the transverse joint or crack and allows for the expansion of the patching material.

Dowel bars assemblies must be centered over the existing transverse joint or transverse crack and parallel to the concrete surface.

Figure 52 shows the assembled dowel bars, chairs, end caps and foam core boards on a flat bed trailer. Dowel bar assemblies are taken from the flat bed trailer, placed adjacent to the dowel bar slot locations (Figure 53 and Figure 54) and inserted into the dowel bar slot (Figure 55). Figure 56 shows the dowel bar assembly at a transverse joint location and Figure 57 and Figure 58 shows the dowel bar assembly at transverse cracks.

Dowel bar assemblies.
Figure 52: Dowel bar assemblies.

Dowel bar assemblies.
Figure 53: Dowel bar assemblies.

Dowel bar assemblies.
Figure 54: Dowel bar assemblies.

Inserting dowel bar assemblies into slots.
Figure 55: Inserting dowel bar assemblies into slots.

Dowel bar assembly at a transverse joint.
Figure 56: Dowel bar assembly at a transverse joint.

Dowel bar assembly at a transverse crack.
Figure 57: Dowel bar assembly at a transverse crack.

Dowel bar assembly at a transverse joint.
Figure 58: Dowel bar assembly at a transverse joint.

Prior to installation, the dowel bar epoxy coating should be inspected and if any discrepancies are present the dowel bar should be rejected. On one dowel bar retrofit failure, dowel bar corrosion (Figure 59 and Figure 60) was determined to be the cause of the dowel bar slot failure.

Corroded epoxy coated dowel bars.
Figure 59: Corroded epoxy coated dowel bars.

Corroded epoxy coated dowel bars.
Figure 60: Corroded epoxy coated dowel bars.

Placement of Patching Material

Patching material can be batched using a mobile mixer (Figure 61 and Figure 62) or in individual batches. If a mobile mixer is used, batching of the individual components must be closely monitored to ensure proper proportioning.

Mobile mixer.
Figure 61: Mobile mixer.

Delivery of materials to mobile mixer.
Figure 62: Delivery of materials to mobile mixer.

Patching material should not be dumped directly into the dowel bar slot; the impact of the patching material falling directly into the dowel bar slot will cause movement of the dowel bar assembly. The patching material should be placed adjacent (Figure 63 and Figure 64) to and spread with shovel (Figure 65) toward and into the dowel bar slot.

Placing patching material.
Figure 63: Placing patching material.

Placing patching material.
Figure 64: Placing patching material.

Moving patching material.
Figure 65: Moving patching material.

Placement of patching material that causes movement (Figure 66 and Figure 67) of the dowel bar assembly should be rejected and replaced.

Movement of bar during placement.
Figure 66: Movement of bar during placement.

Misaligned foam core board.
Figure 67: Misaligned foam core board.

Patching material consolidation should be conducted with a pencil (or similar) vibrator (Figure 68). Care must be taken to not relocate the dowel bar assembly during consolidation.

Consolidating patching material.
Figure 68: Consolidating patching material.

Figure 69 and Figure 70 illustrate patching material voids in the vicinity of the dowel bar. The core shown in Figure 69 was taken from the first dowel bar retrofit project and illustrates lack of consolidation beneath the dowel bar, which could be due to aggregate size and the inability to move the aggregate around the dowel bar or lack of consolidation. Figure 70, on the other hand, was taken from a more recent project (2006) and shows lack of consolidation around and above the bar. In this case, it was determined that the aggregate gradation was too large to adequately fit around the bar and WSDOT modified specifications to allow only AASHTO Grading No. 8 (prior to this project, either AASHTO Grading No. 7 or 8 was allowed).

Poor consolidation.
Figure 69: Poor consolidation.

Poor consolidation.
Figure 70: Poor consolidation.

During the finishing process, care should be taken to not overwork the patching material (Figure 71 and Figure 72). Overworking can lead to segregation and floating of the fine material to the surface of the dowel bar slot. The fine material is susceptible to wear, especially when subjected to studded tires. Patching material should be left ⅛ inch to ¼ inch high (Figure 73 and Figure 74), which will be removed during the diamond grinding process.

Finishing patching material.
Figure 71: Finishing patching material.

Finishing patching material.
Figure 72: Finishing patching material.

Patching material should be left high to prevent overworking.
Figure 73: Patching material should be left high to prevent overworking.

Patching material left high to minimize segregation.
Figure 74: Patching material left high to minimize segregation.

Curing compound should be applied (Figure 75) to the patching material as soon as possible after the finishing operation.

Applying curing compound.
Figure 75: Applying curing compound.

Establishing the transverse joint within the dowel bar slots (Figure 76) should be conducted within 24 hours after placement. If the transverse joints were originally constructed with a tape joint and the joint is uneven (Figure 77), the transverse joint should not be sawcut. In this situation, sawcutting a straight line would be challenging without creating slivers that would eventually spall.

Establishing joint in patching material.
Figure 76: Establishing joint in patching material.

Transverse tape joint (original construction).
Figure 77: Transverse tape joint (original construction).

Figure 78 illustrates damage caused by mechanically sweeping the roadway prior to the patching material reaching the required strength. As before, the methodology for repairing this distress is to saw cut, remove and replace two to three inches of the distressed material.

Mechanical sweeping prior to patching material reaching strength.
Figure 78: Mechanical sweeping prior to patching material reaching strength.

Studded tire wear is one of the more predominant distresses affecting pavement (both HMA and concrete) performance in Washington State. For dowel bar retrofit, the largest impact of studded tires is wear in the dowel bar slot (Figure 79 and Figure 80).

Wear due to studded tires.
Figure 79: Wear due to studded tires.

Wear due to studded tires.
Figure 80: Wear due to studded tires.

Diamond Grinding

Diamond grinding (Figure 81 through Figure 83) should begin within 10 working days of placing dowel bar retrofit patching materials. The primary reason for this specification is to minimize traveler complaints related to intentionally leaving dowel bar patching material high.

Diamond grinding equipment.
Figure 81: Diamond grinding equipment.

Diamond grinding equipment.
Figure 82: Diamond grinding equipment.

Diamond grinding equipment.
Figure 83: Diamond grinding equipment.

Slurry Removal
Removal of the grinding residue from the roadway surface should occur immediately after grinding. Slurry should not be allowed to drain across open traffic lanes and shoulders. Slurry should not be allowed to drain into any waterway, placed on the roadway slope within 200 feet of any waterway, or other areas as designated by the Engineer.

The agencies environmental section should be consulted during the dowel bar retrofit design regarding concrete slurry removal. Some projects will allow slurry to be placed on the roadway slopes while some areas, depending on environmental requirements, will require that the slurry be deposited (and treated as necessary) off site.

Reseal Joints and Cracks

Research studies have been conducted for determining the benefits of resealing concrete joints. There will be no attempt to determine the economic benefits of joint resealing in this document, however, it is recommended that all joints and cracks be cleaned and sealed following the diamond grinding process. The primary reasons are to remove any debris and diamond grinding slurry from joints and cracks and to minimize the amount of water and incompressibles from entering the pavement structure through the joints and cracks.

Completed Product

Figure 84 and Figure 85 illustrate successful completion of the dowel bar retrofit process.

Completed roadway.
Figure 84: Completed roadway.

Close-up of completed dowel bar retrofit.
Figure 85: Close-up of completed dowel bar retrofit.
